Project Context: The "Matrouh Residential Tower" is a high-density vertical development project. The structure features a complex load profile, integrating a Commercial Ground Floor with six typical residential floors and a Roof Services level. This project was not a simple drafting exercise; it was a comprehensive Systems Engineering challenge requiring the coordination of Lighting, Power, and HVAC loads into a unified, code-compliant infrastructure.
Technical Standards: The design philosophy was grounded in rigorous compliance. I utilized the Egyptian Code for Electrical Installations for local regulation adherence and IEC 60364 Standards for international best practices. All calculations—from cable derating to short-circuit withstand ratings—were cross-referenced with Dr. Mahmoud Gilany’s "Electrical Installations Reference" and technical specifications from the Elsewedy Cables Catalog.
A robust engineering project begins with data structure. Before drawing a single cable, I established a rigorous file management protocol based on the industry-standard "Project Tree" methodology.
I segregated the project environment into IN folders (for received XREFs from Architecture and Mechanical disciplines) and OUT folders (for Electrical deliverables). This prevented version conflicts and ensured that I was always designing on the latest architectural footprint.
Received architectural backgrounds often contain excessive visual noise (hatching, furniture details, decorative dimensions). I performed a rigorous cleaning process:

I rejected the "Rule of Thumb" approach in favor of computational verification. Using DIALux Evo, I simulated the entire floor plate to ensure every room met the lux levels required by the code.
I integrated the Philips Lighting Plugin to select high-efficacy LED fixtures.
Once photometric calculations were approved, I exported the fixture coordinates back to AutoCAD Electrical to finalize the construction drawings.

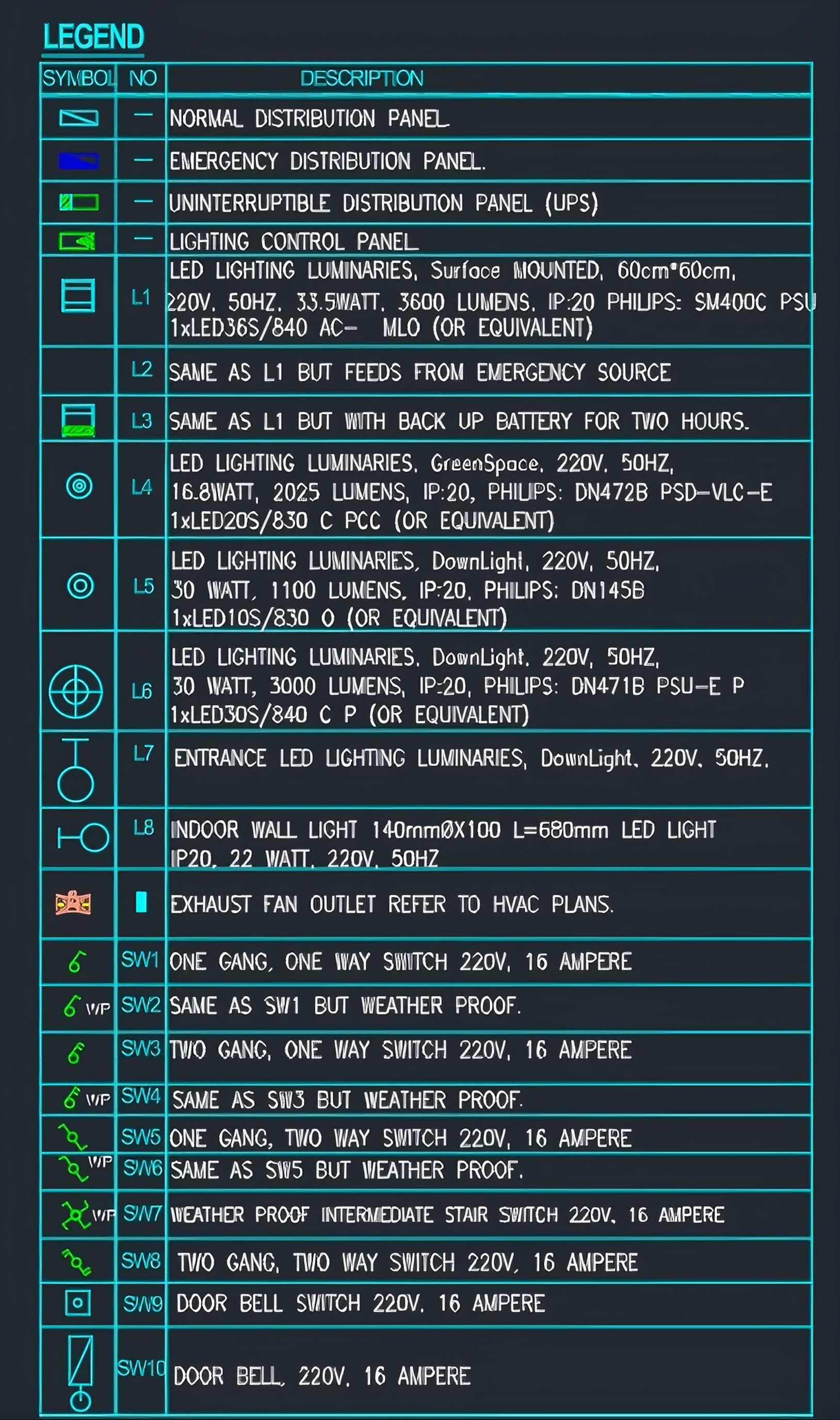

The image on the right (Fig 3.2) shows the Project Standard Legend. I adhered strictly to these symbols to ensure that site engineers and contractors had zero ambiguity regarding mounting heights, lamp types, and IP ratings.
I applied a strict Circuit Segmentation Strategy:
No more than 3 rooms were placed on a single lighting circuit. This ensures that if a breaker trips due to a fault in one room, the entire apartment does not plunge into darkness—reliability through segmentation.

The power layout was engineered to balance user convenience with strict safety codes. I adhered to the "Furniture Layout" method to place sockets where they are actually needed.
I enforced the spacing rule: no point along a wall can be more than 1.8m from an outlet. This effectively means placing sockets every 3.6m to minimize the use of dangerous extension cords.

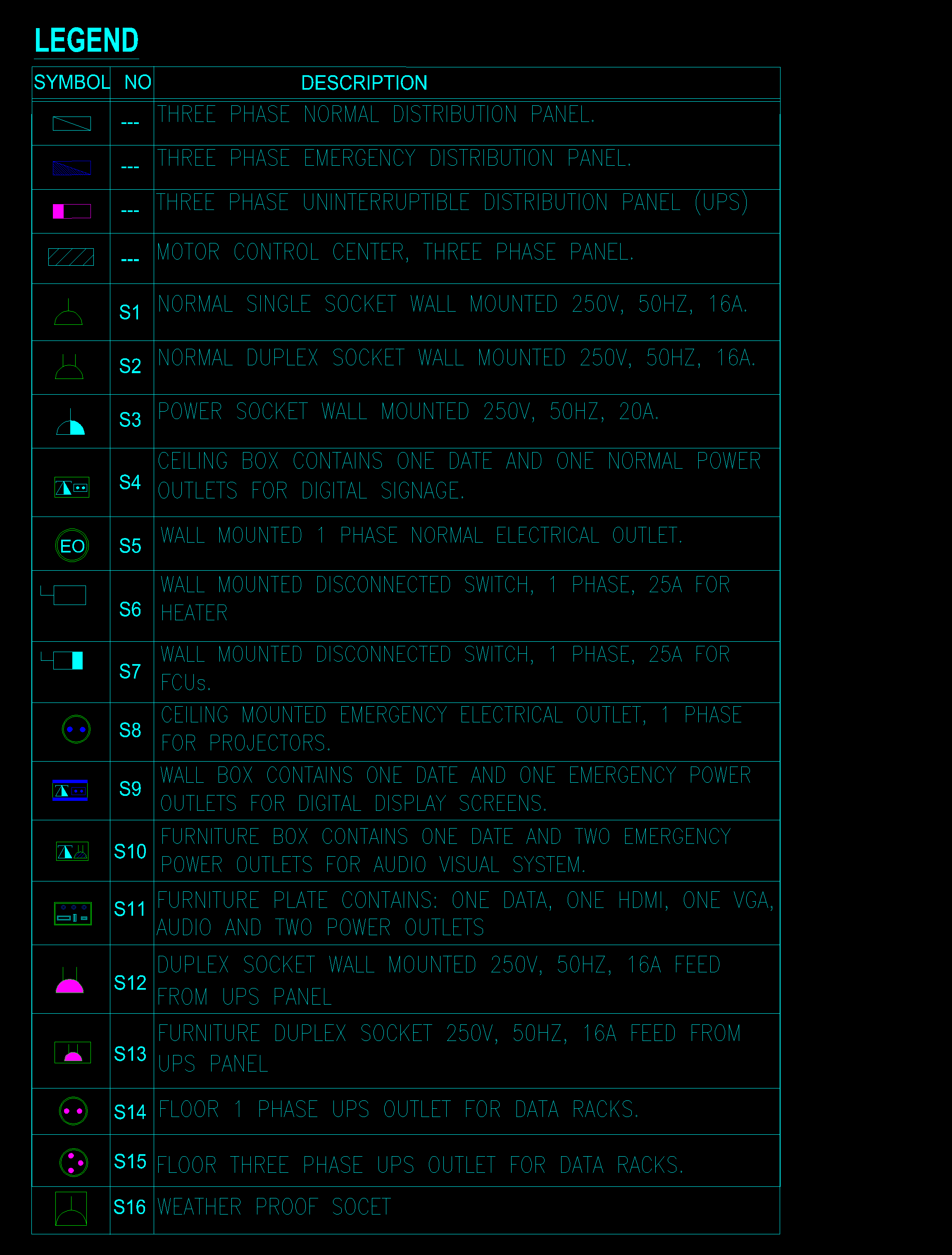

Electrical design cannot exist in a vacuum. I coordinated extensively with the HVAC drawings to ensure every mechanical unit had robust power delivery.
I placed dedicated Double Pole (DP) Switches (20A/32A) adjacent to every Split AC unit and Electric Water Heater.
Engineering Reason: This provides a local point of isolation, allowing maintenance personnel to safely service the unit without accessing the main panel.
Specified IP55 Weatherproof Isolators for balcony units and IP65 Isolators for Roof units to prevent water ingress faults.
This was the most mathematically intensive phase. I utilized advanced Excel schedules to size the breakers and calculate the Total Demand Load for the building.
Sized MCBs using a 1.25 safety factor. Applied IEC Diversity Factors to avoid oversizing the transformer.
| Load Type | Design Current | Breaker | Diversity Factor |
|---|---|---|---|
| Lighting | ~4-5 A | 10A (C-Curve) | 0.66 |
| Sockets | ~8-10 A | 16A (C-Curve) | 0.40 |
| Split AC | ~7 A | 20A (D-Curve) | 1.00 (None) |
I balanced single-phase loads across Red, Yellow, and Blue phases to minimize neutral current.
Result: Imbalance < 1% (R: 10.8kVA, Y: 10.7kVA, B: 10.8kVA).
The final engineering step was designing the vertical backbone (Riser) that feeds all 6 floors.
I selected Cu/XLPE/PVC cables from the Elsewedy Catalog. However, choosing cables based on "Air" rating is dangerous. I applied rigorous Derating Factors:
Verified that voltage drop at the furthest socket (Level 6) remained below 5%.
Calculation: Vd = (mV/A/m) × Ib × L / 1000 = 2.8% (PASSED).
The final deliverable was a precise BOQ to allow contractors to price the project accurately. I utilized AutoCAD Data Extraction to ensure < 2% variance.
